Everything it does, before any page explains any part of it:

- The plant is described oncethe batch vessel sizes the batch, the last stage's counter gives the good count; nobody types a quantity.
- The formula is signed before the plant may run itapproving a new version retires the old in the same breath, and every batch keeps the copy it ran with.
- One press mints the orderevery batch, its window and the line's own tags; a wash, a changeover or a shutdown is planned, not suffered.
- Nobody presses startthe line begins and ends its own jobs from two signals, stamped with the plant's own clock.

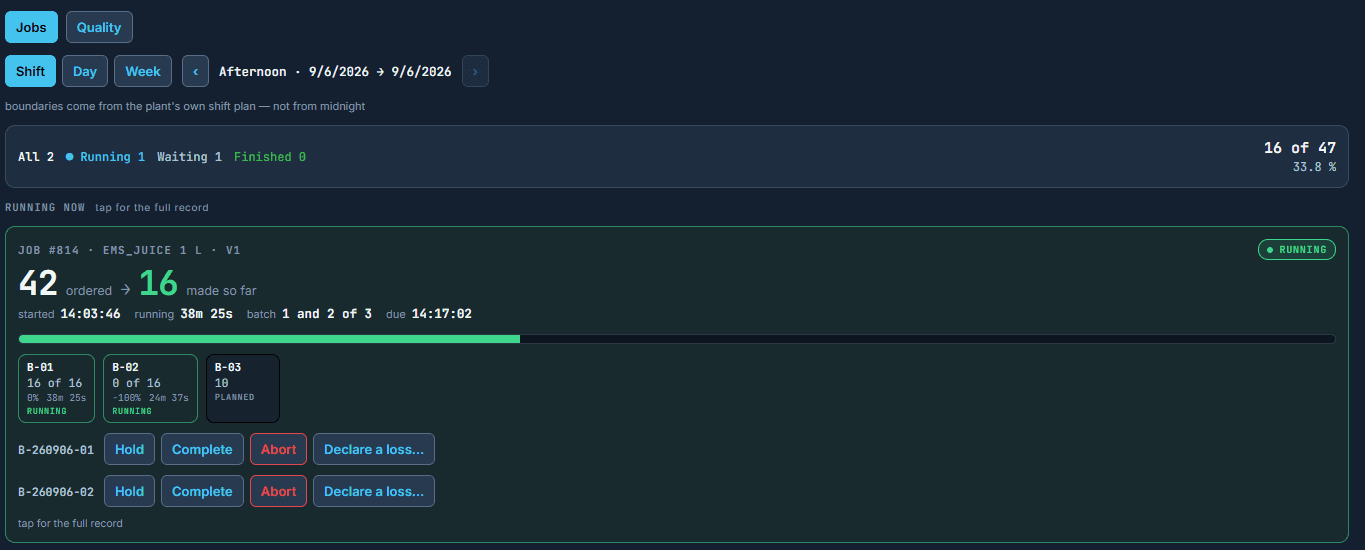

- Batches overlap, because lines doand you choose who decides a boundary, the plant or the counters, and change it live within a minute with no restart.
- Every number says who measured itcounted, declared, or held by the arithmetic; the lab's signed count outranks the machine counter and both stay on the record; what cannot be known stays blank, never zero.

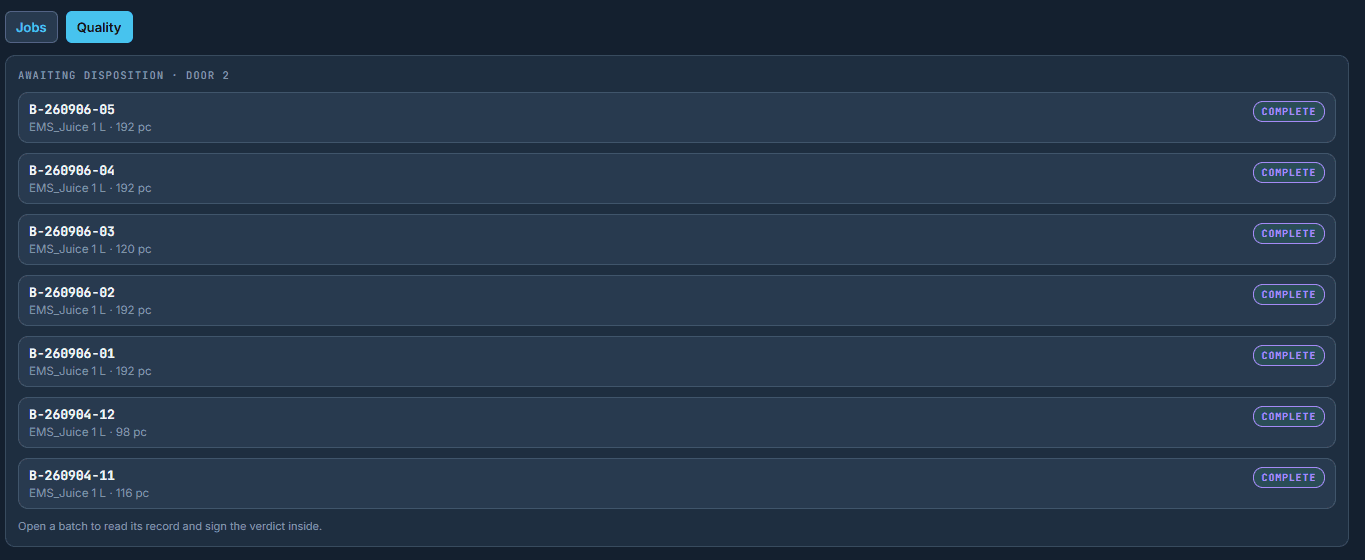

- The board an operator can read from the aisleone card per job, the batches as chips, the next boundary forecast — and the Quality door signed from the same screen.
- No second store, no batch server, no line of code at the edgethe certificate prints from the engine that prints the shift handover.
You want it, the line already knows how.
- You want
- What SOP does
- The door
| You want | What SOP does | The door |
|---|---|---|

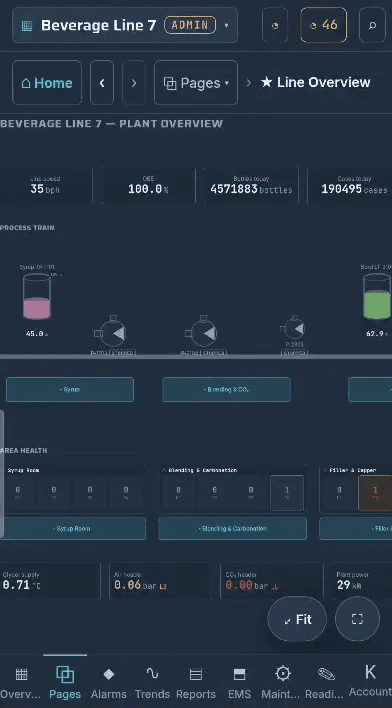

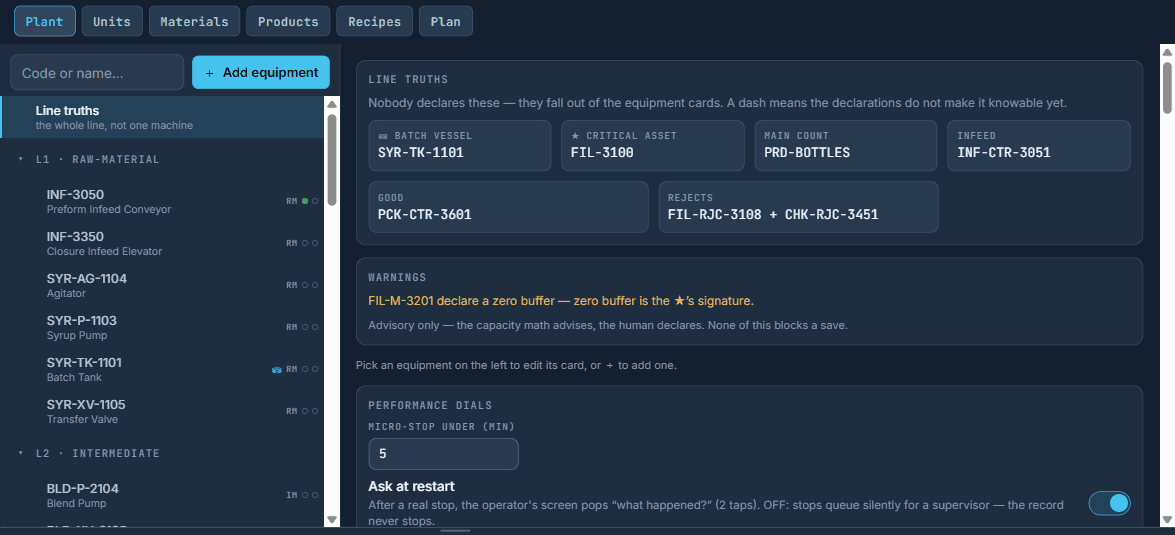

| The plant written down once, in the order the product travels | Every machine takes a level and a stage, and the line reads its own shape back to you | the engineer's EMS · Plant |

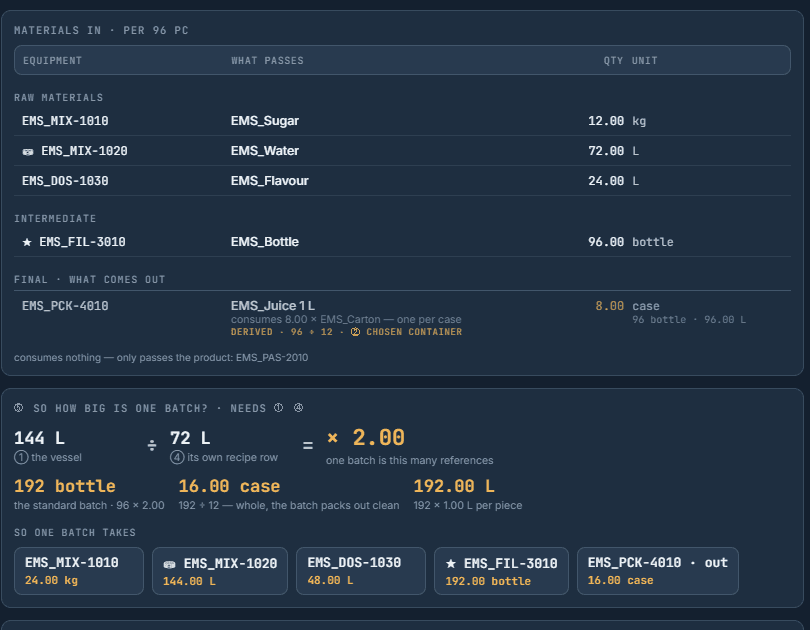

| One vessel to decide how big a batch is | Mark it the batch vessel with its capacity, its unit and what it holds. The batch size follows; nobody types a quantity | Plant · the machine card |
| The good count to come off the right machine | Name the last stage and point it at its counter. Every batch end and every yield figure is read there | Plant · the machine card |

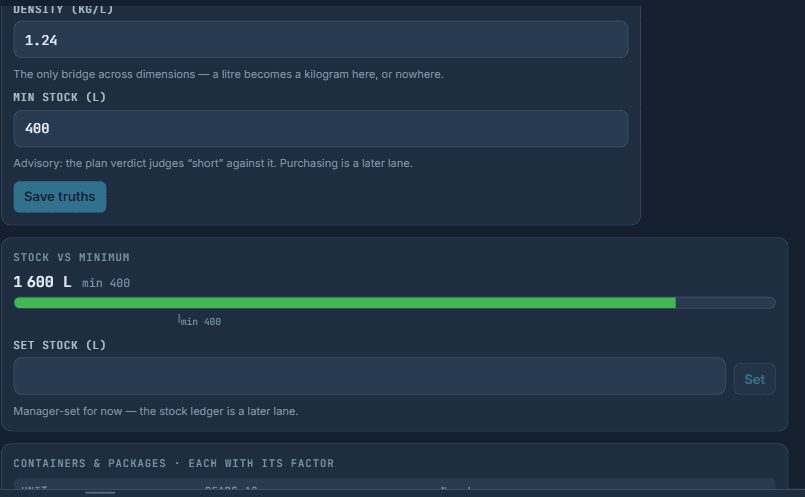

| A catalogue the plan can do arithmetic with | Materials carry what they are, what one of them is, what is on hand and the density that lets weight and volume cross | the engineer's EMS · Materials |
| What the line makes, and how it is packed | A product carries its base unit, what one piece holds, and a ladder of package sizes, biggest first | the engineer's EMS · Products |

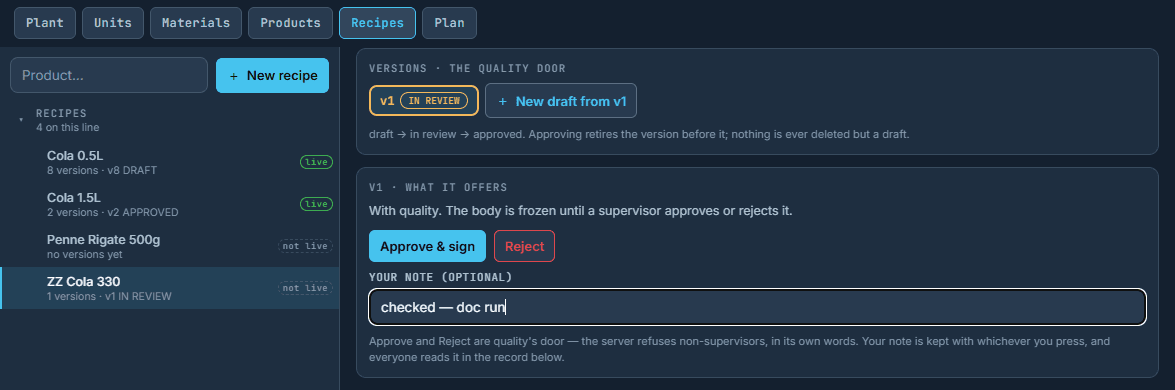

| A formula the plant may not run until quality signs it | Draft, in review, approved. A supervisor approves and signs; approving retires the one before it | the engineer's EMS · Recipes |
| A second formula for the same product, running beside the first | Give the recipe its own name and its own timeline. One line can hold several | EMS · Recipes |

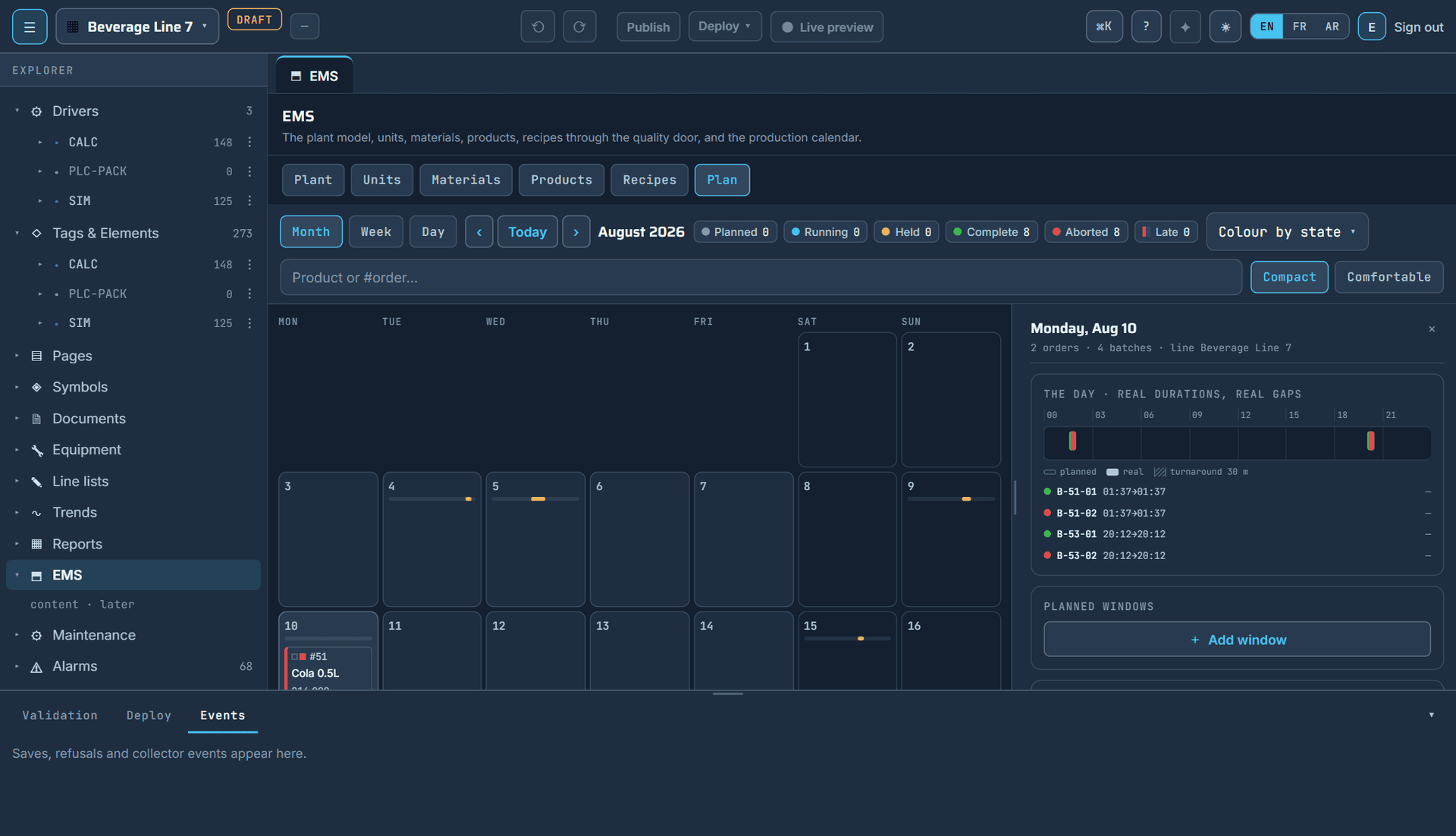

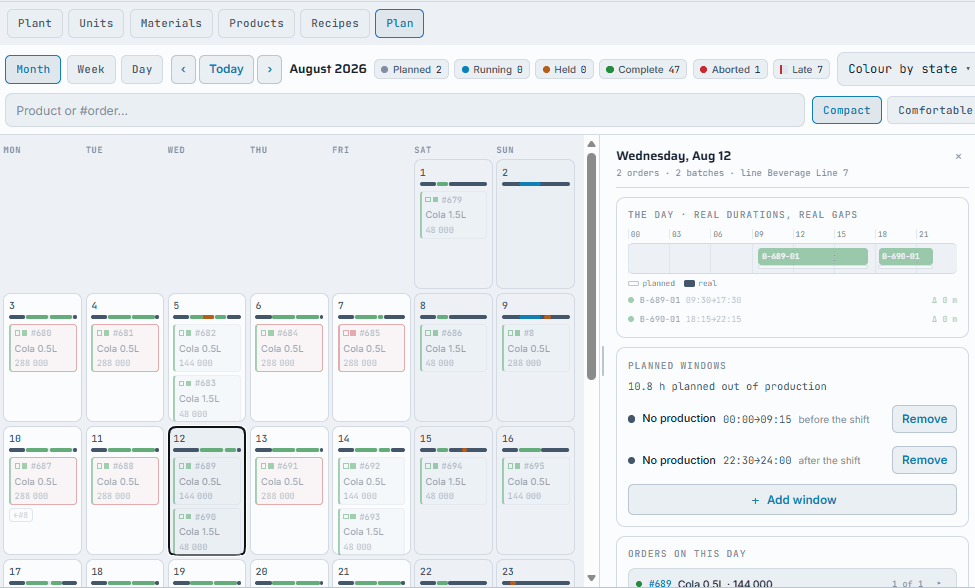

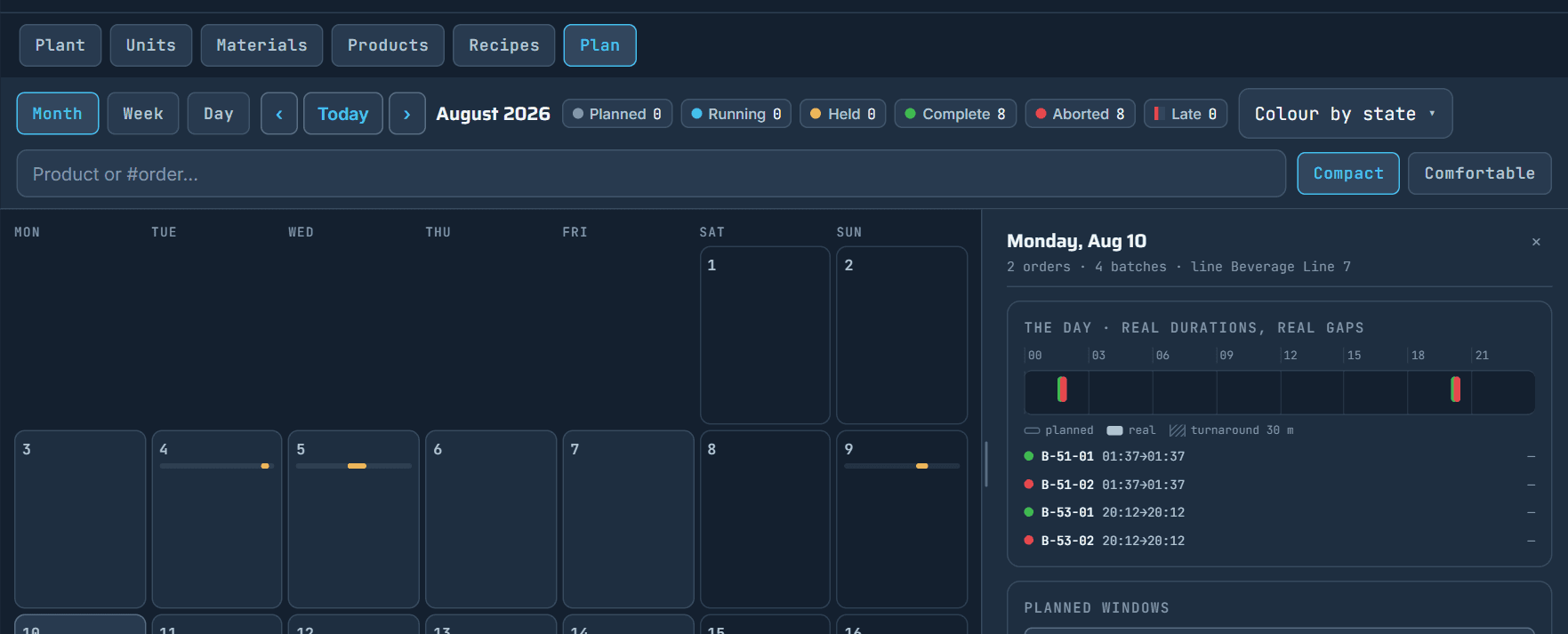

| Next week on a calendar | Pick a day, one recipe, one number, one start time. The order, every batch, its window and the line's own tags are minted in one press | the engineer's EMS · Plan |
| A wash, a changeover or a shutdown to be planned, not suffered | Declare the window on the day. The plan lays the batches around it and the performance number honours it | Plan · the day panel |

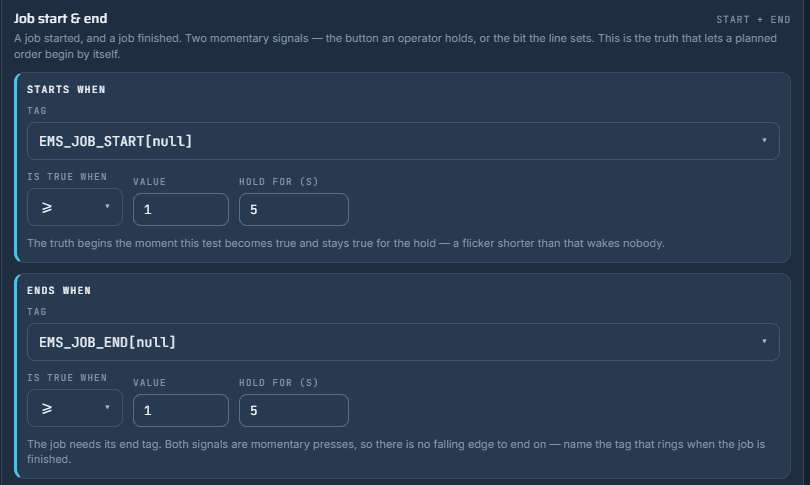

| The line to start and finish its own jobs | Name the signal that rings when a job begins and the one that rings when it is done. A planned order then begins by itself | Plant · the line's truths |
| The plant to say when a batch is charged and when it is finished | Declare those two signals and the plant decides. Leave them alone and the vessel and the last machine's counters decide instead | Plant · the line's truths |

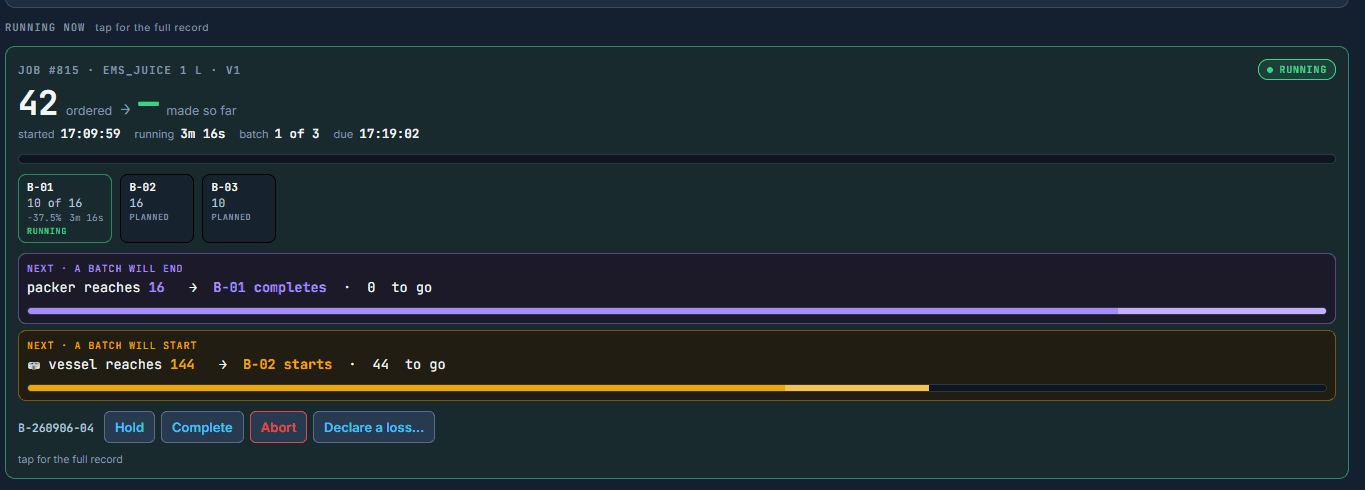

| What is running now, what is next, and how far it has to go | The board draws it: one card per job, its batches as chips, and the machine and number the next boundary is waiting on | the operator's EMS · Jobs |

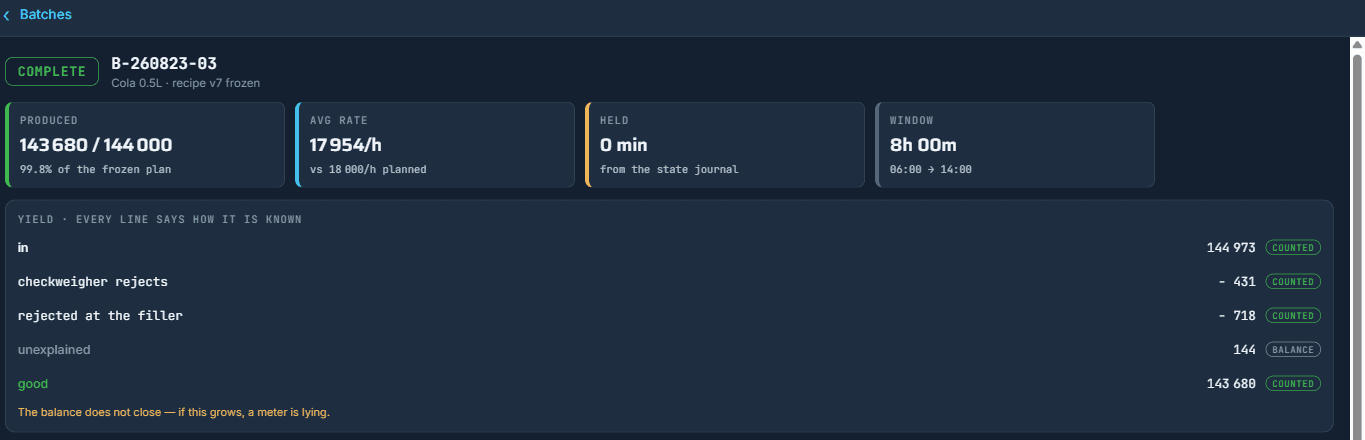

| A batch that came out off plan to find you | Set a tolerance and a time limit on the job. A batch outside either turns amber, shows its own arithmetic and asks one supervisor for one signature | Jobs · the job settings, then the chip |

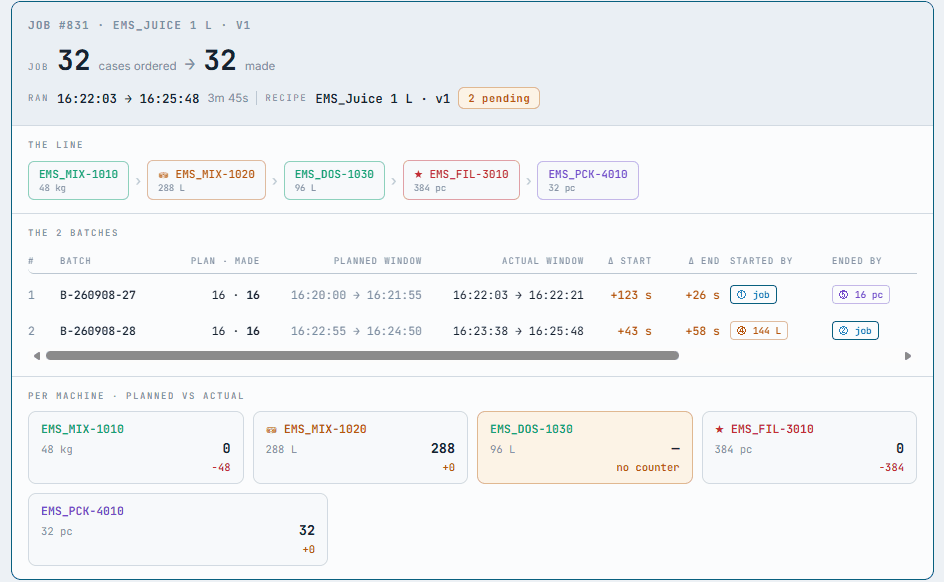

| The whole job read back, batch by batch, and signed | Tap the card. The record opens in place: what moved every boundary, planned against actual per machine, planned against used per material, then the two signatures | Jobs · the record |
Everything above is one module on the database the SCADA already writes. There is no second store, no batch server and no line of code at the edge.
